 |
 |

|

|

|
1:40
p.m. CDT April 2, 2016

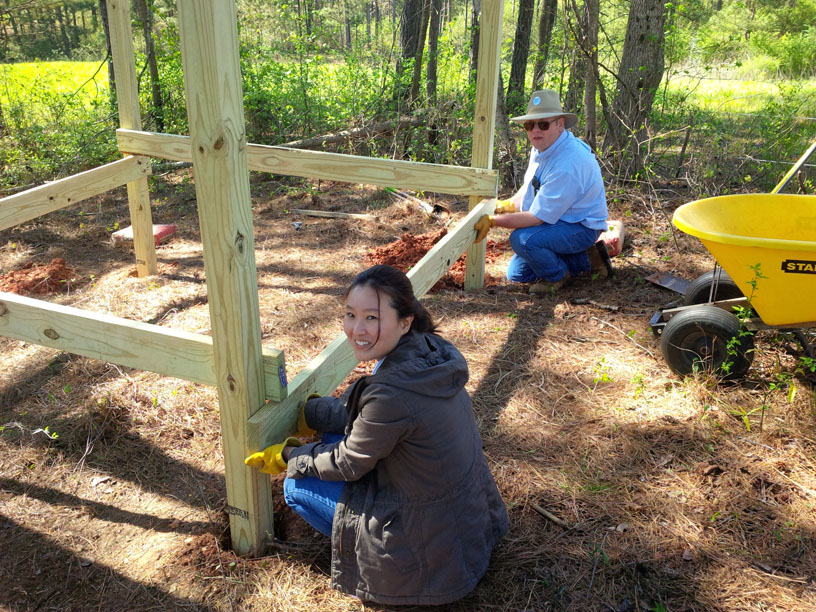

Mark and Tim getting started
|
3:22
p.m. CDT April 2, 2016
My wife assisting us on this day
|
4:25
p.m. CDT April 2, 2016

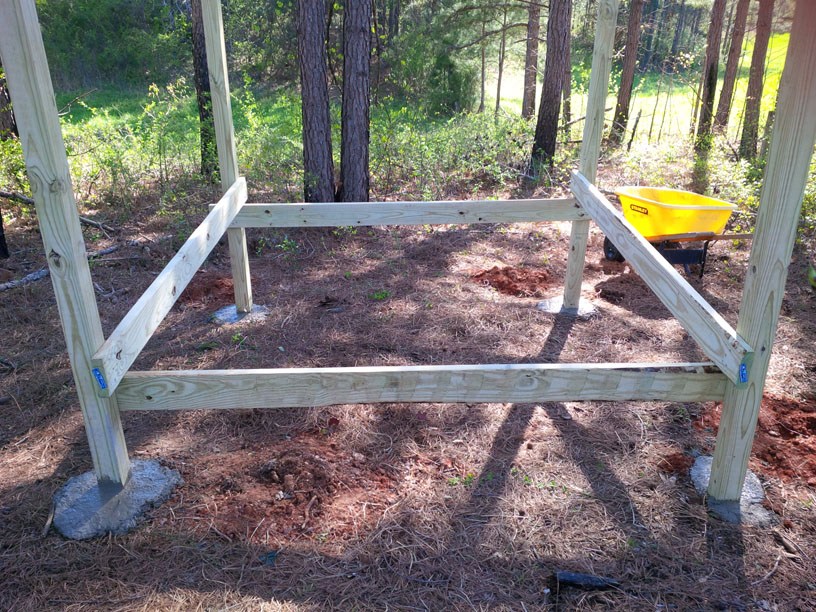

Laying the foundation (concrete)
|
11:18
a.m. CDT April 16, 2016

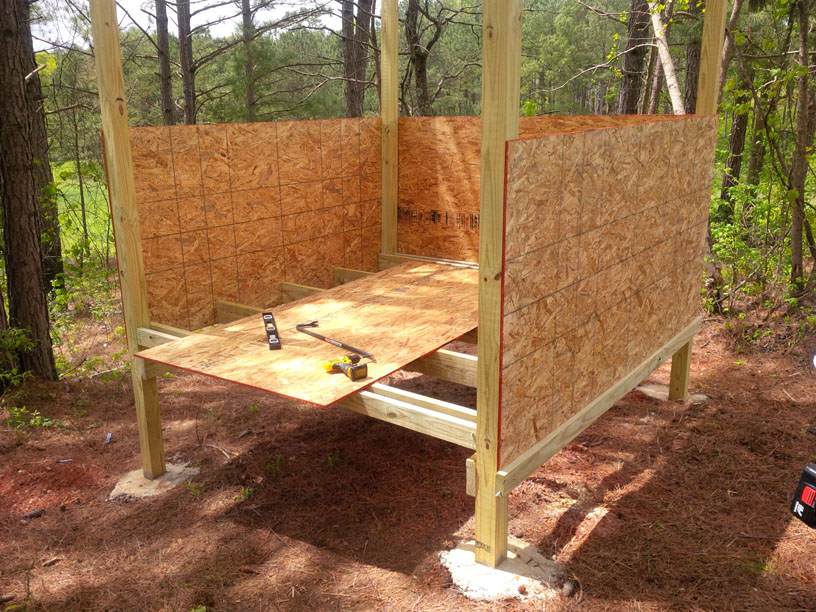

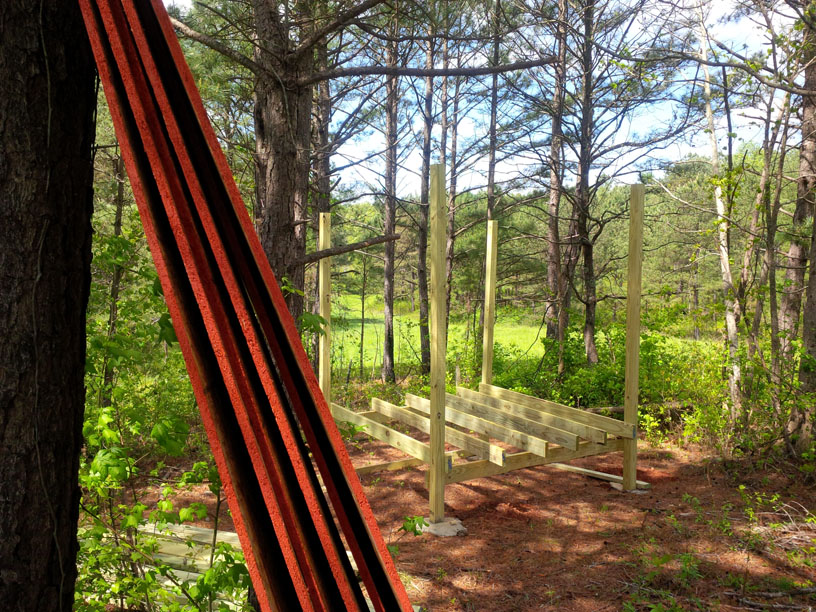

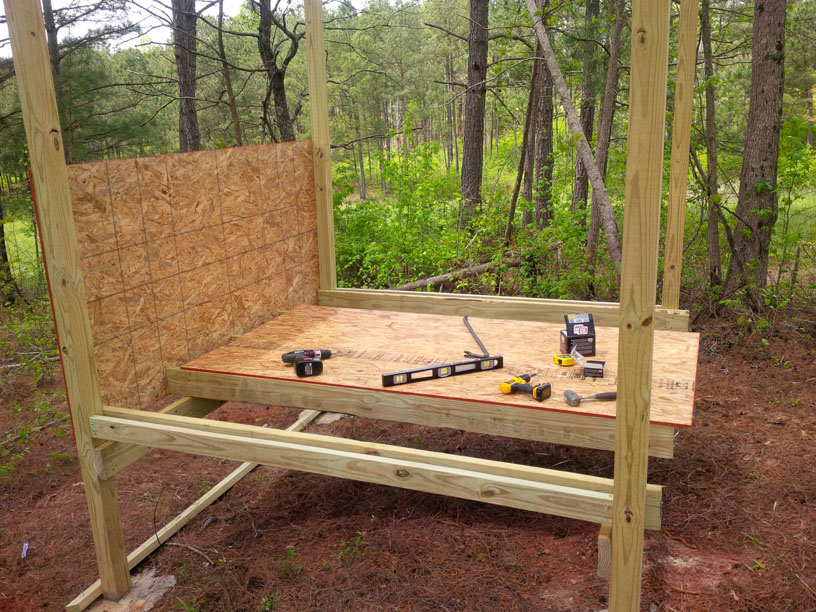

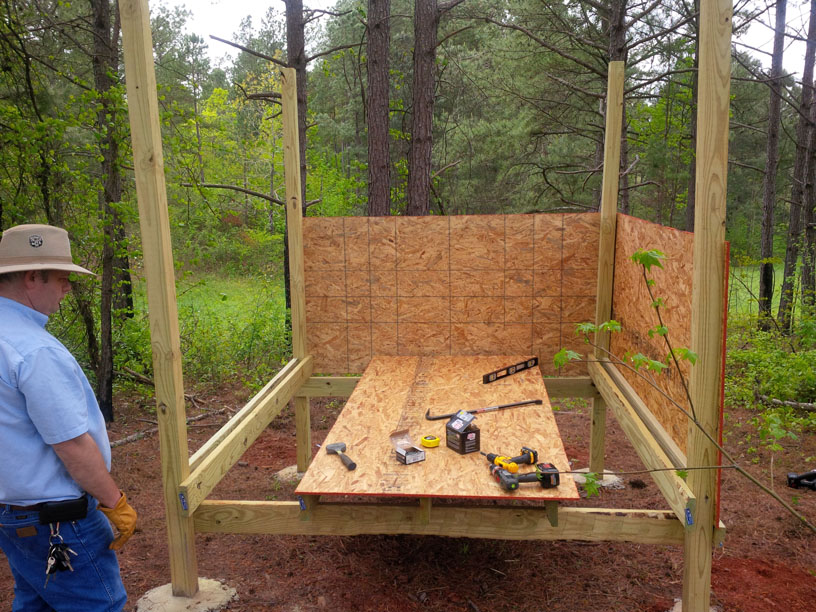

The floor's 2''-by-6'' boards installed
|
1:15
p.m. CDT April 16, 2016
We now have support to stand inside
|

|

|

|

|

|
1:32
p.m. CDT April 16, 2016
Plywood doubles as workbench
|
1:53
p.m. CDT April 16, 2016
Three lower-wall portions installed
|
4:10
p.m. CDT April 16, 2016

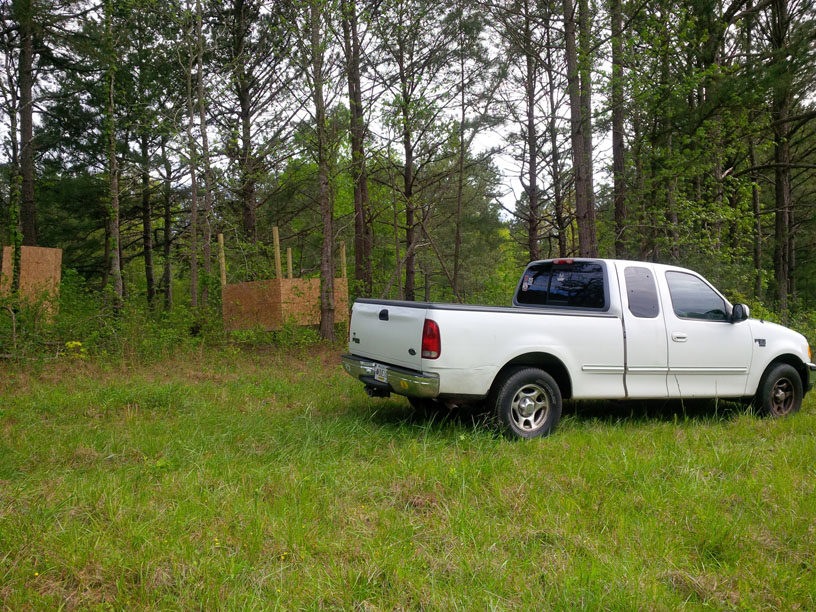

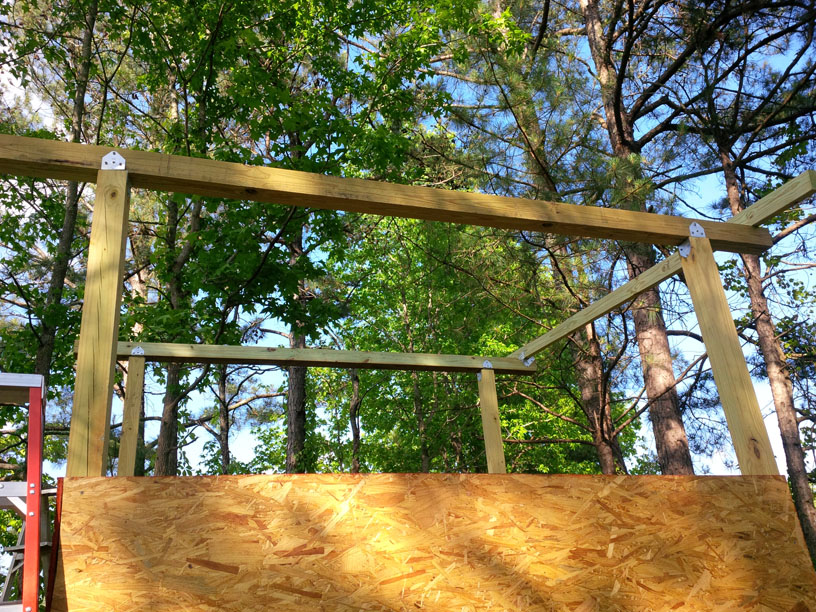

Behind trees, but still accessible
|
4:38
p.m. CDT April 16, 2016

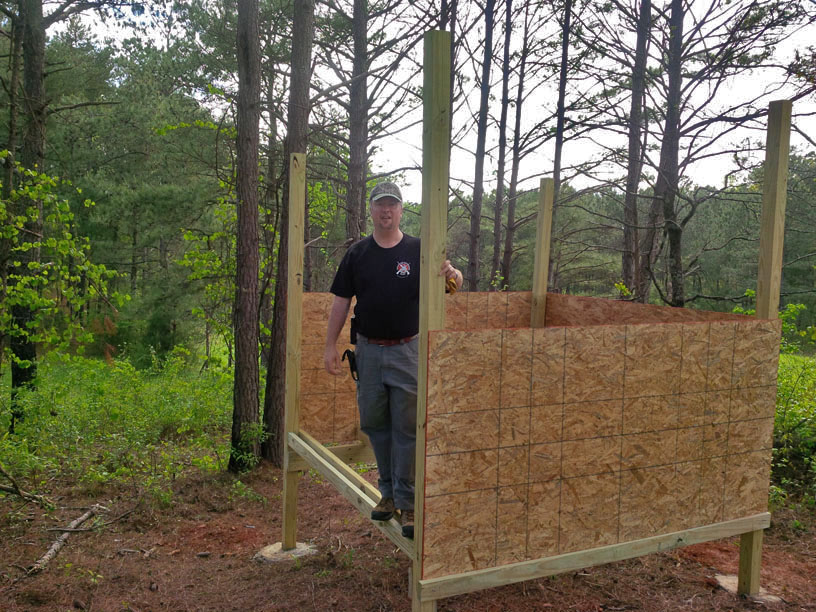

Door will be where I am standing
|

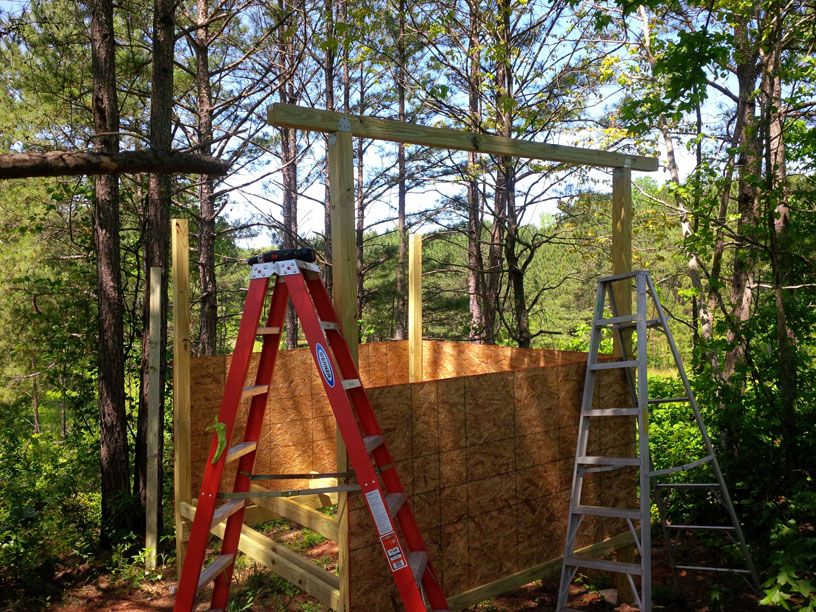

11:08
a.m. CDT May 14, 2016

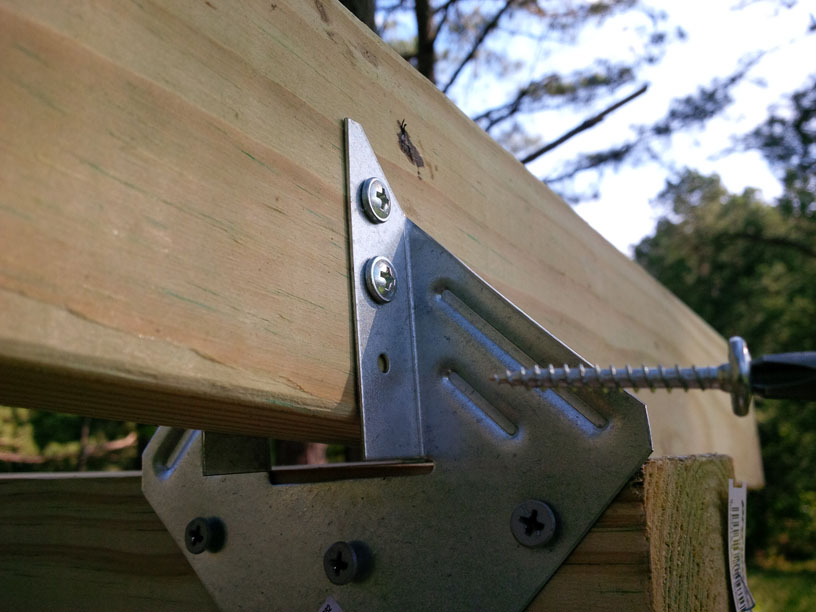

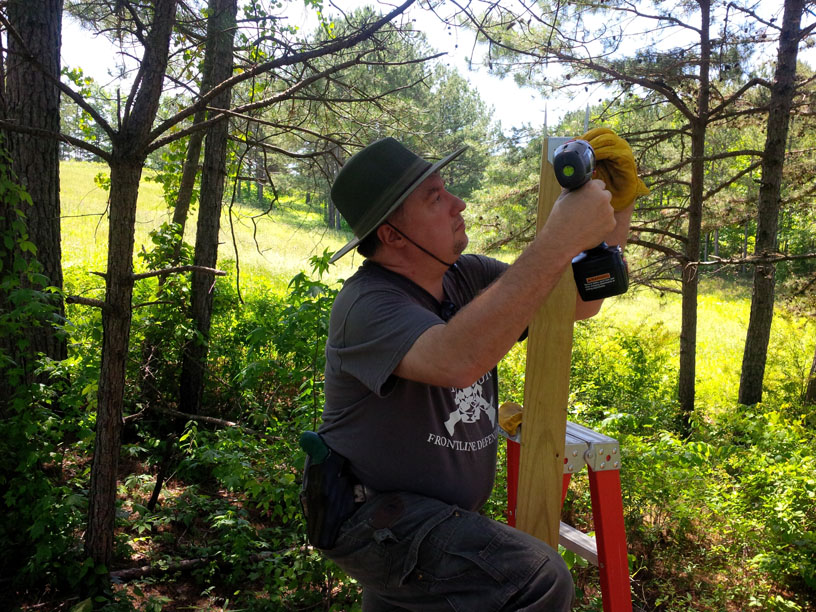

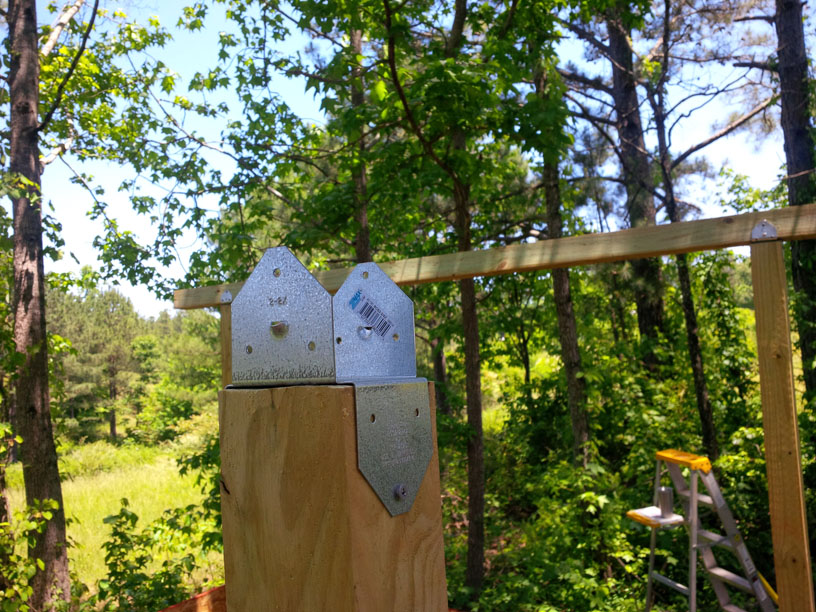

I am installing truss joist bracket
|

|

|

|

|

|
11:23
a.m. CDT May 14, 2016

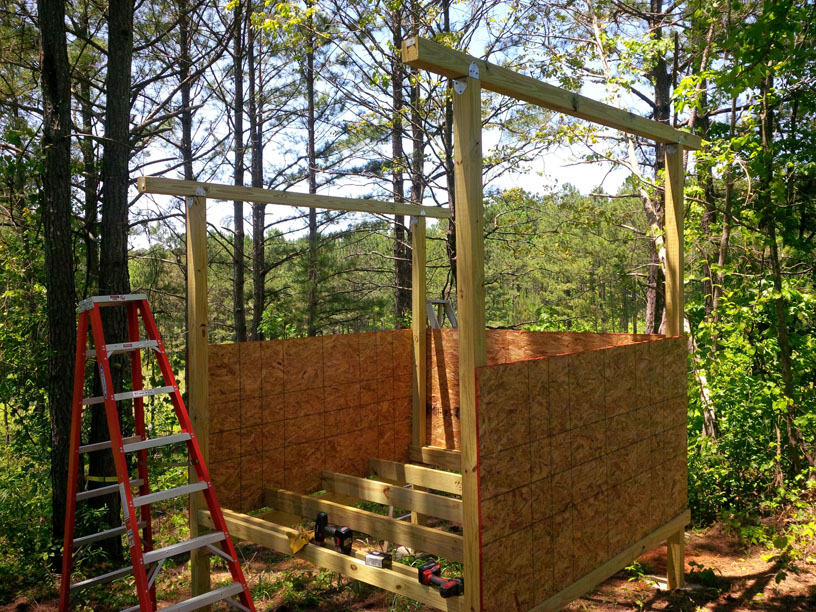

Trusses & vertical supports are 4''x4''
|

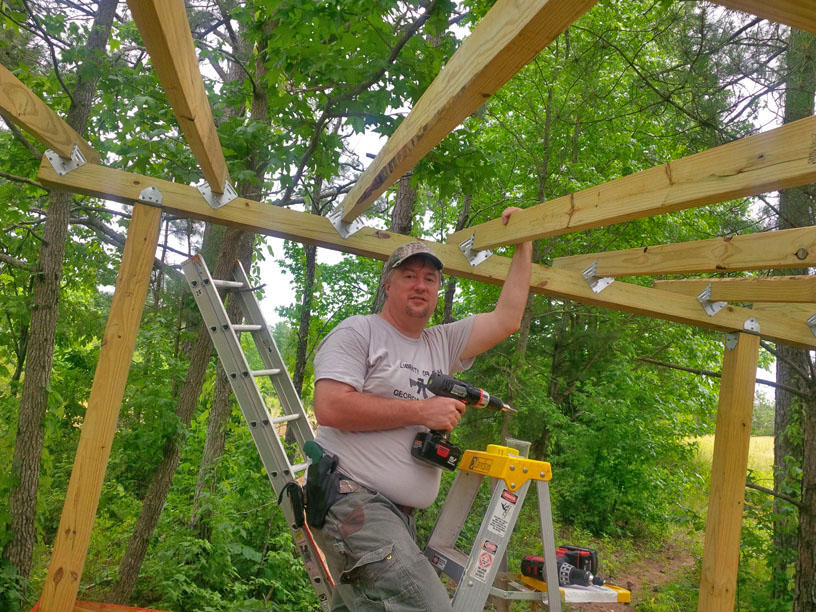

12:04
p.m. CDT May 14, 2016
Open joist bracket before laying truss
|
12:34
p.m. CDT May 14, 2016

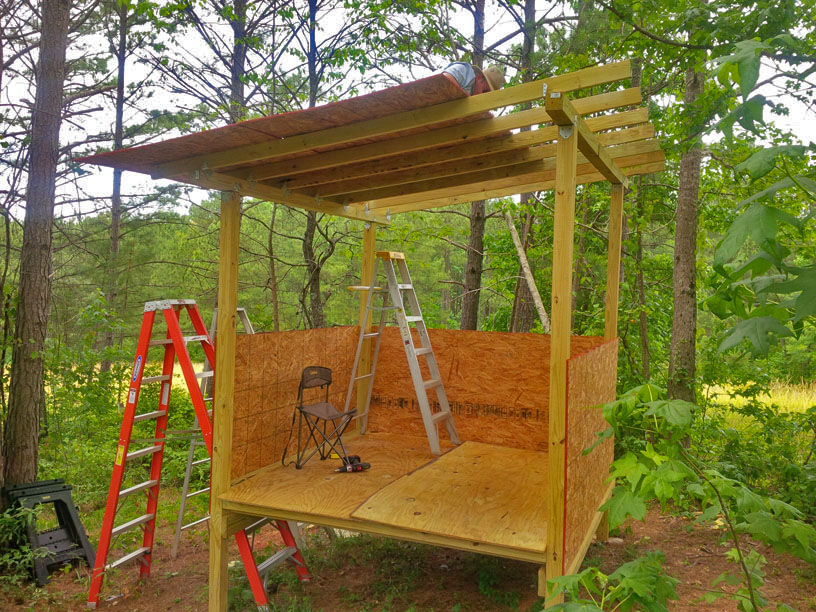

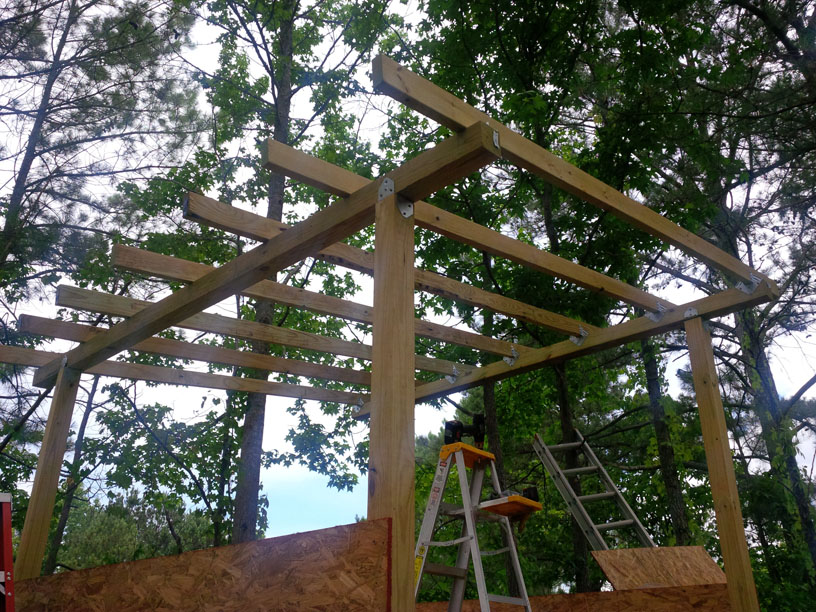

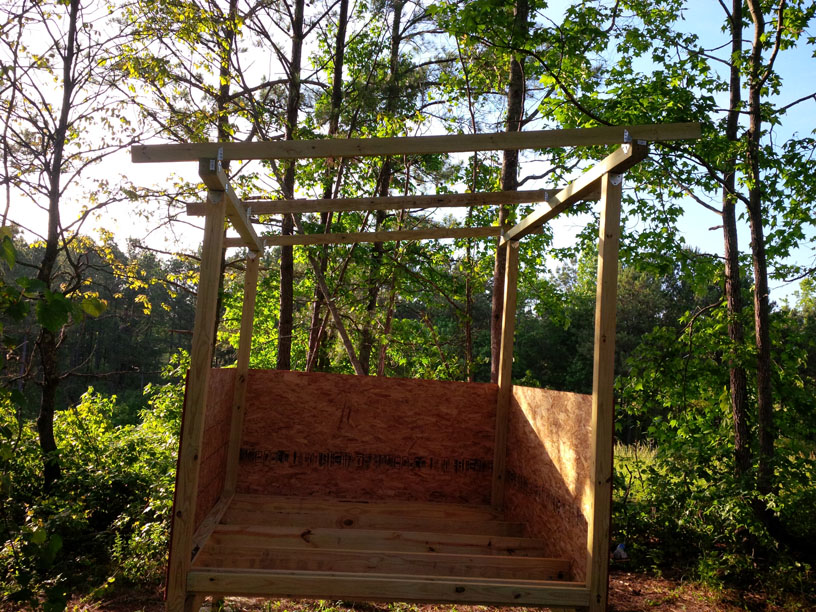

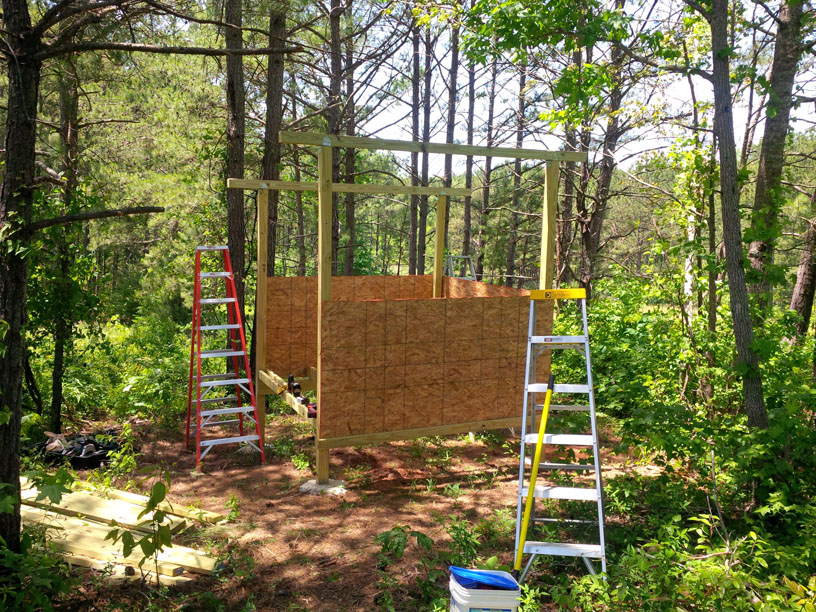

The trusses are completed!
|
12:35
p.m. CDT May 14, 2016
View aside 8-foot ladders
|
4:42
p.m. CDT May 14, 2016

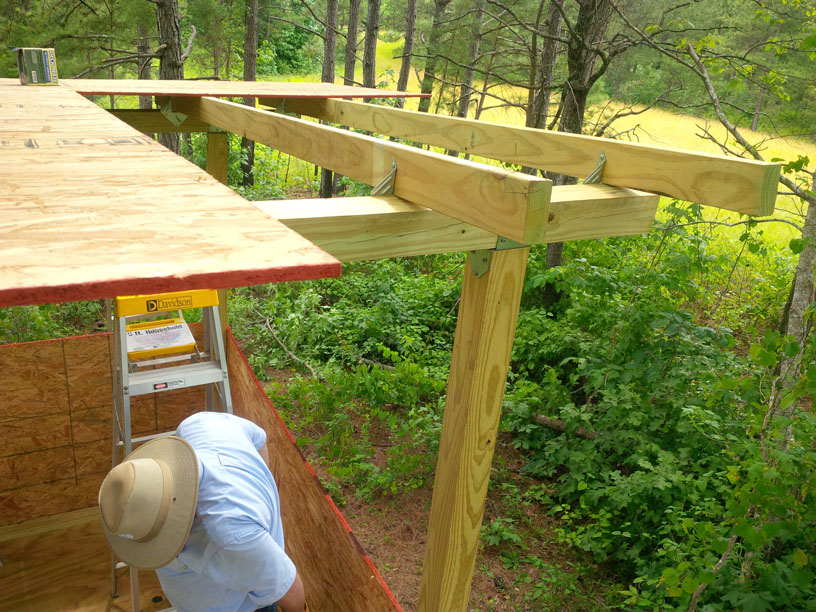

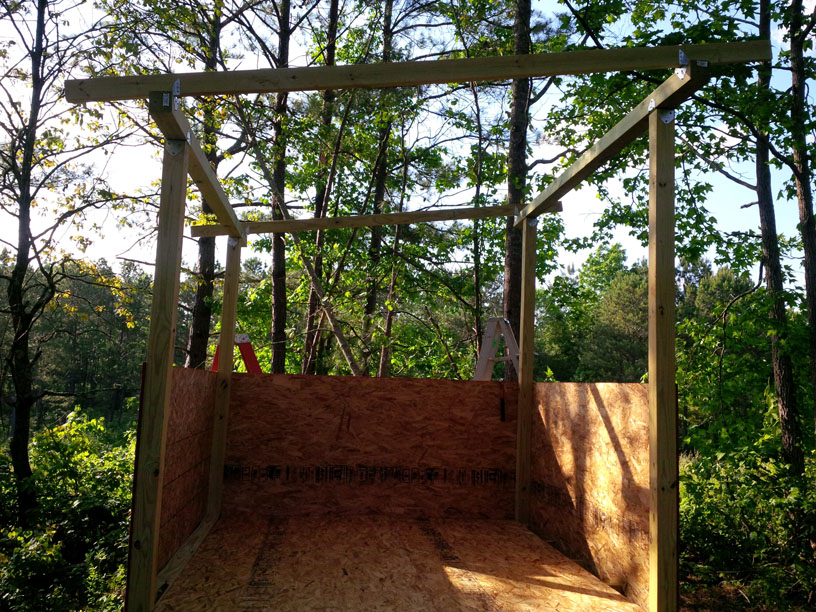

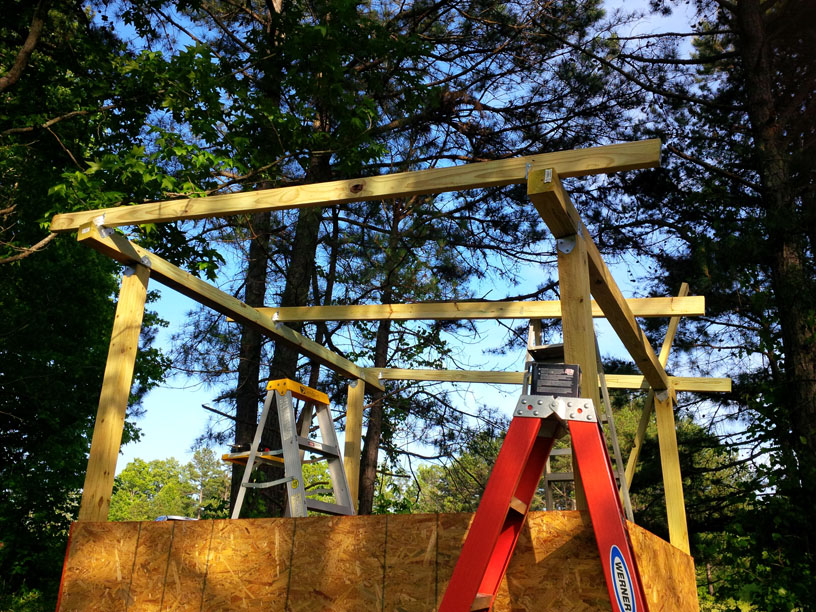

Work starts on the rafters
|

|

|

|

|

|
4:58
p.m. CDT May 14, 2016
|

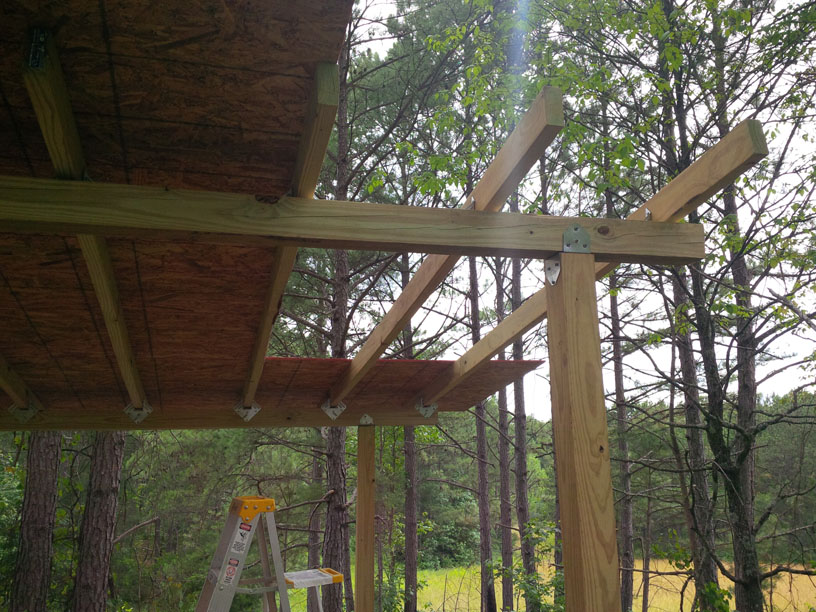

5:13
p.m. CDT May 14, 2016
Upper frame completed!
|
5:49
p.m. CDT May 14, 2016 |
6:09
p.m. CDT May 14, 2016
We stop for the weekend with 3 rafters
|
11:27
a.m. CDT June 4, 2016

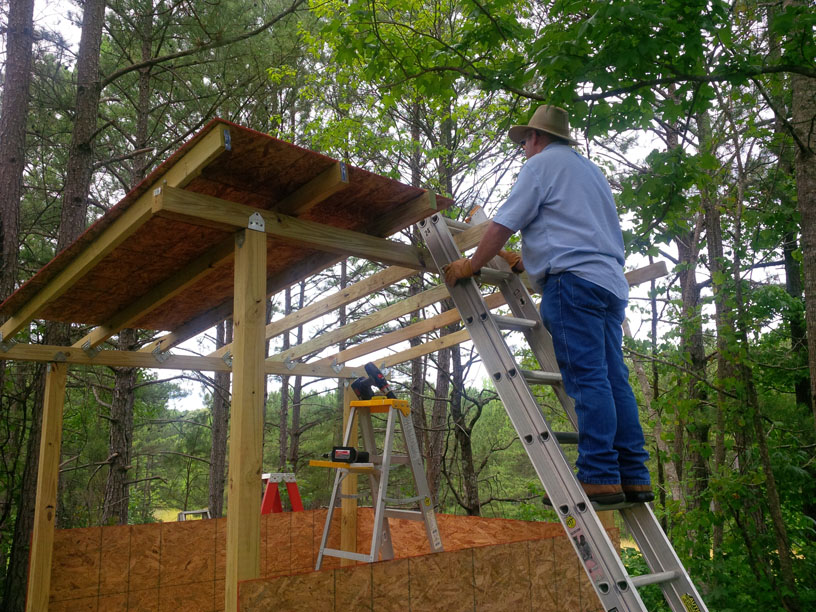

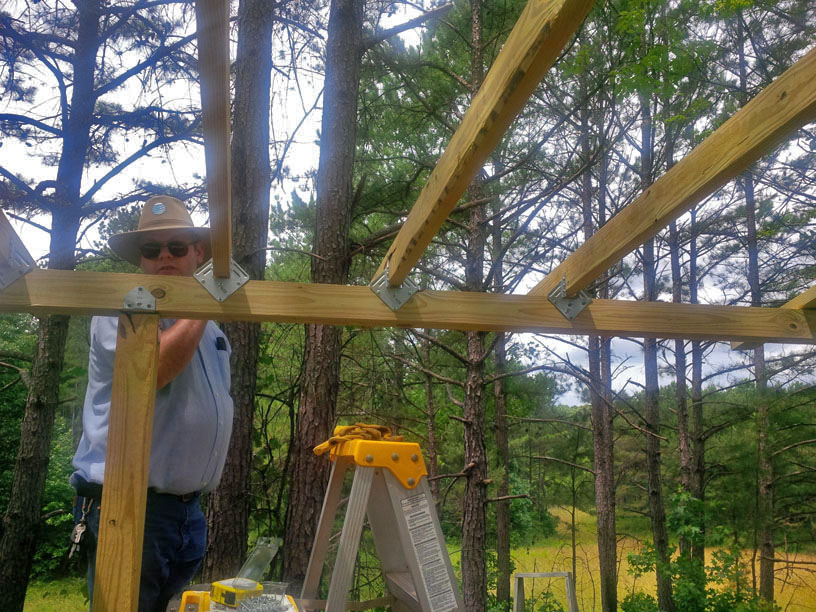

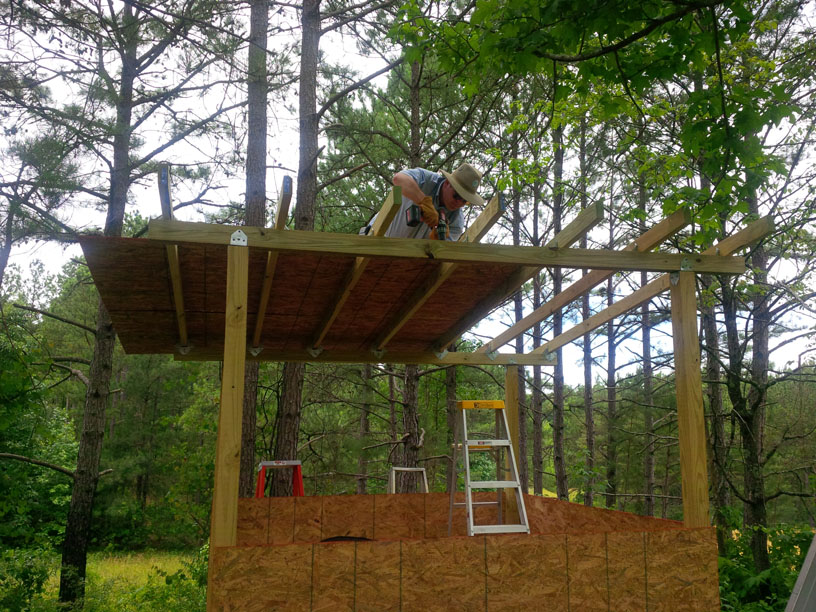

Tim aligning and installing rafters
|

|

|

|

|

|
12:04
p.m. CDT June 4, 2016
Yes... the camera always adds pounds
|
12:05
p.m. CDT June 4, 2016

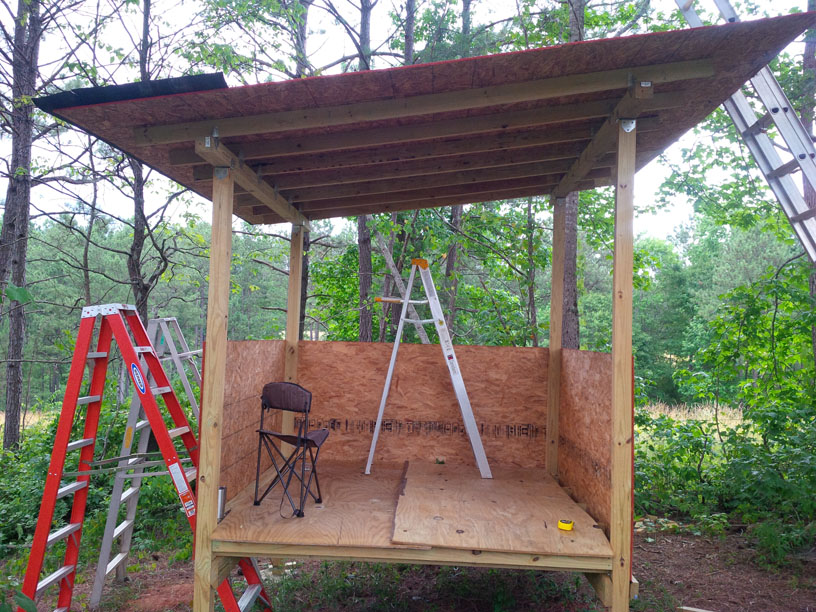

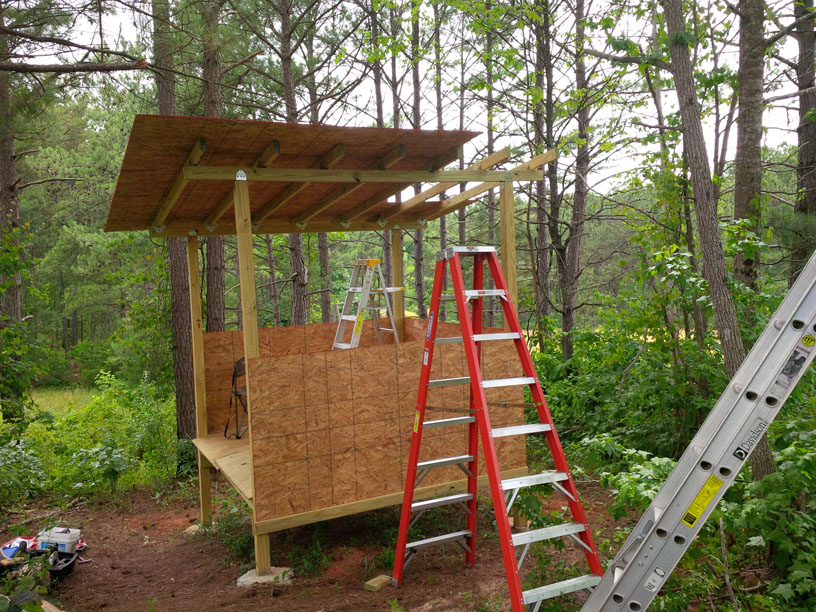

The rafters are completed!
|
12:07
p.m. CDT June 4, 2016

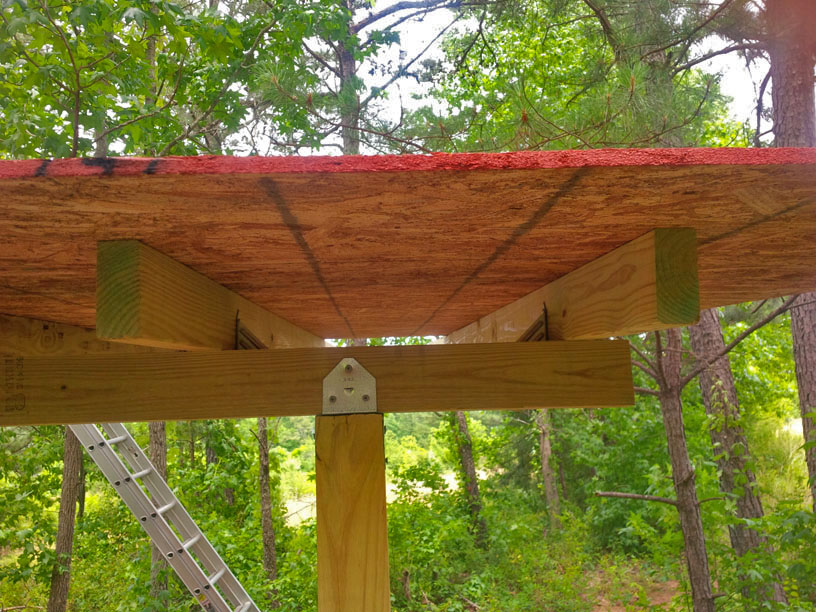

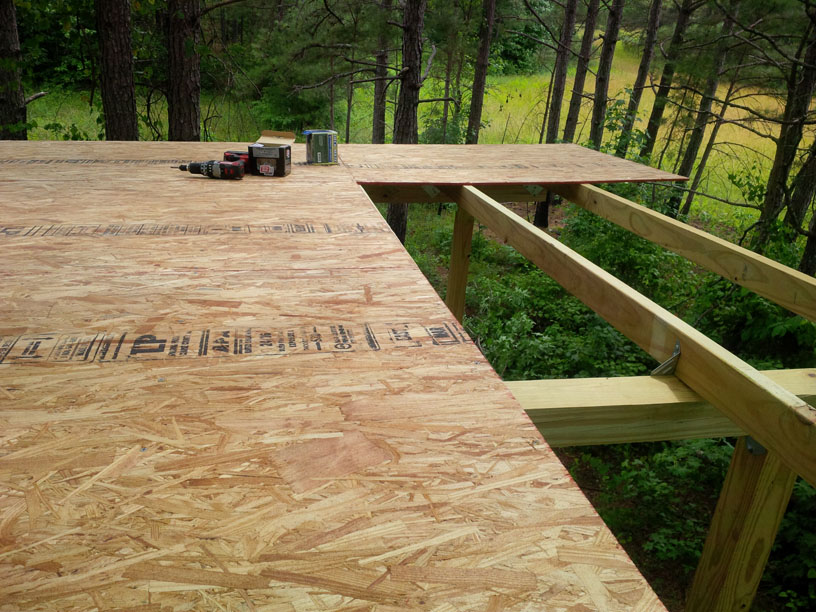

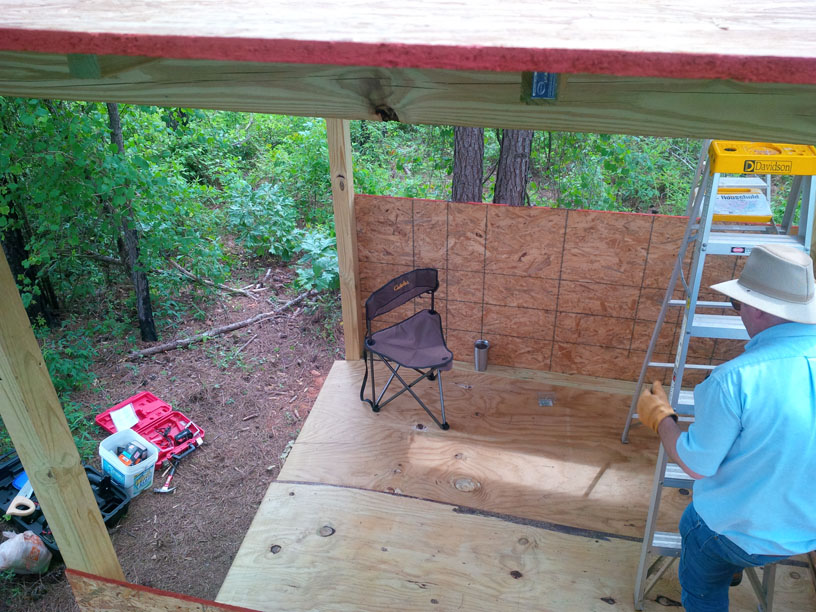

Waferboard roofing begins
|
12:59
p.m. CDT June 4, 2016
Tim is very brave, but determined!
|
1:00
p.m. CDT June 4, 2016
On right, view down into pine grove
|

|

|

|

|

|
1:34
p.m. CDT June 4, 2016
Truss & rafters underneath waferboard
|
3:22

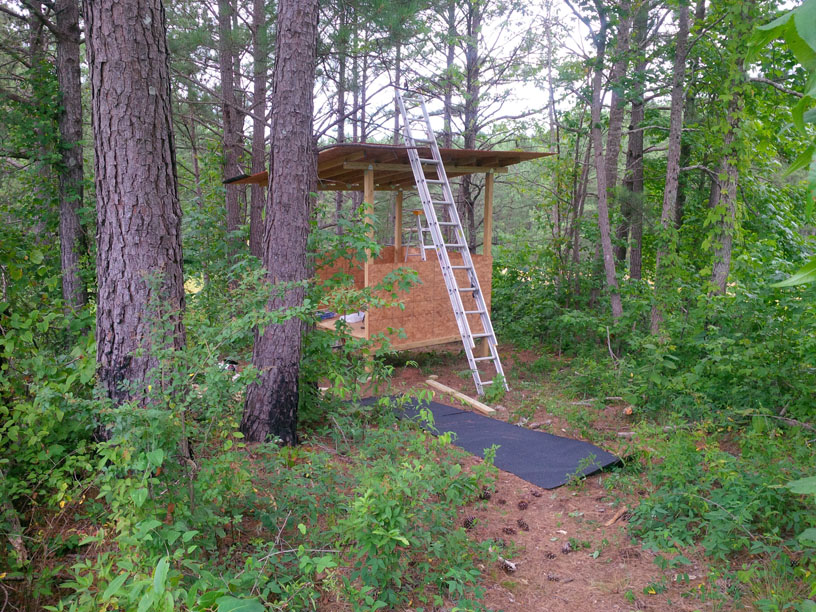

p.m. CDT June 4, 2016 |
3:22
p.m. CDT June 4, 2016 |
3:22
p.m. CDT June 4, 2016 |
3:23
p.m. CDT June 4, 2016 |

|

|

|

|

|
3:23
p.m. CDT June 4, 2016
Right before Tim adds last section
|
4:17
p.m. CDT June 4, 2016

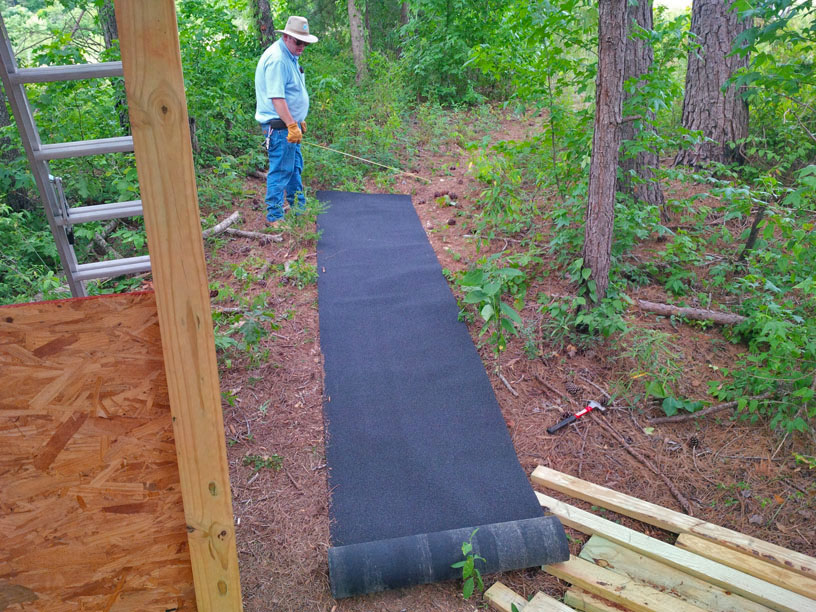

We utilize roll-out shingles for roof
|
4:33
p.m. CDT June 4, 2016
Manage to nail down only one section
|
5:46
p.m. CDT June 4, 2016

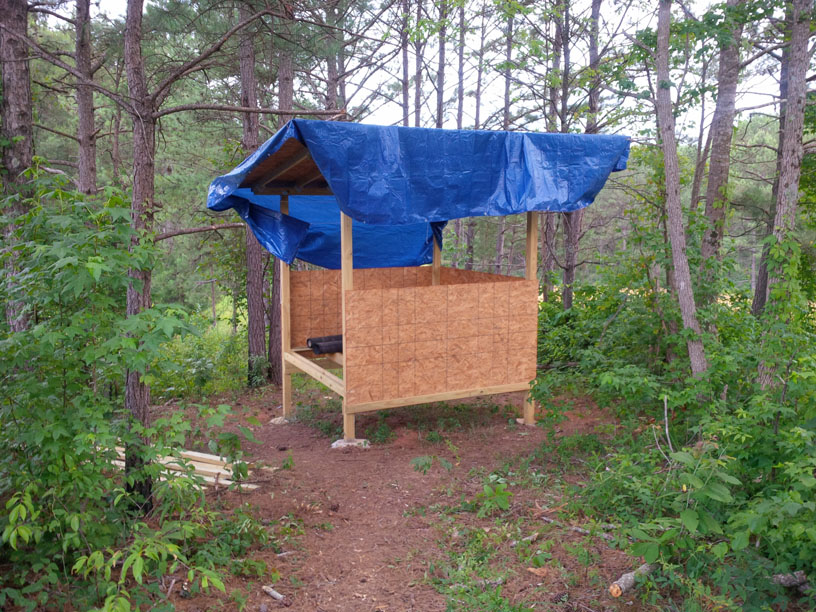

Not enough roofing material...
|
6:24
p.m. CDT June 4, 2016

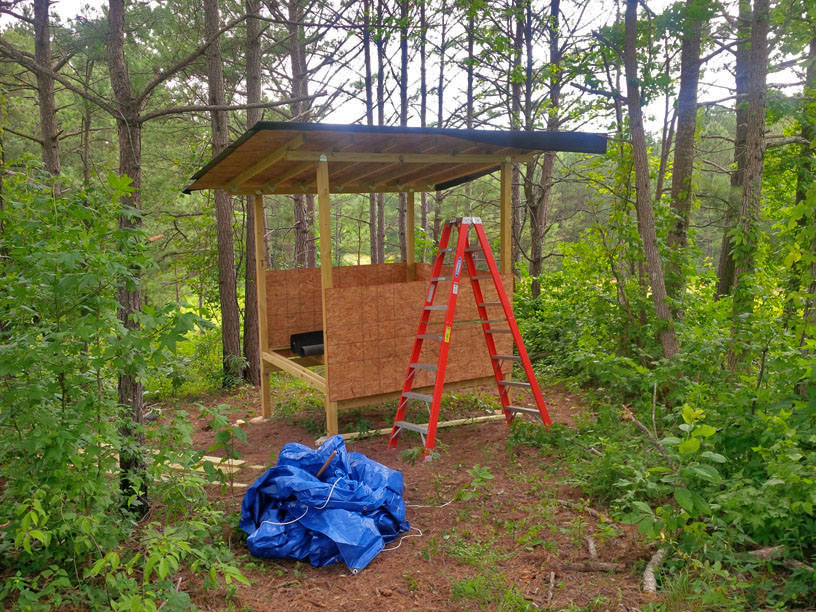

...then the rains came!
|

|

|

|

|

|
2:46
p.m. CDT June 18, 2016

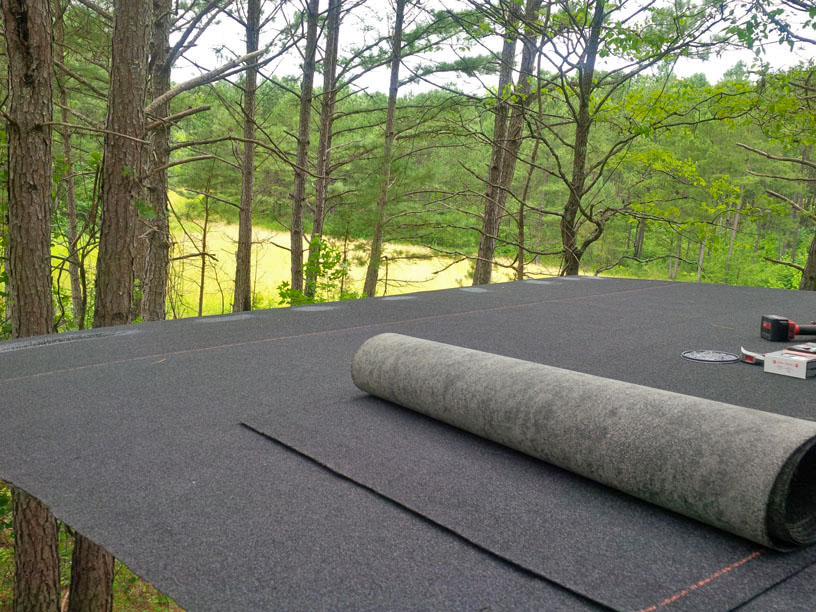

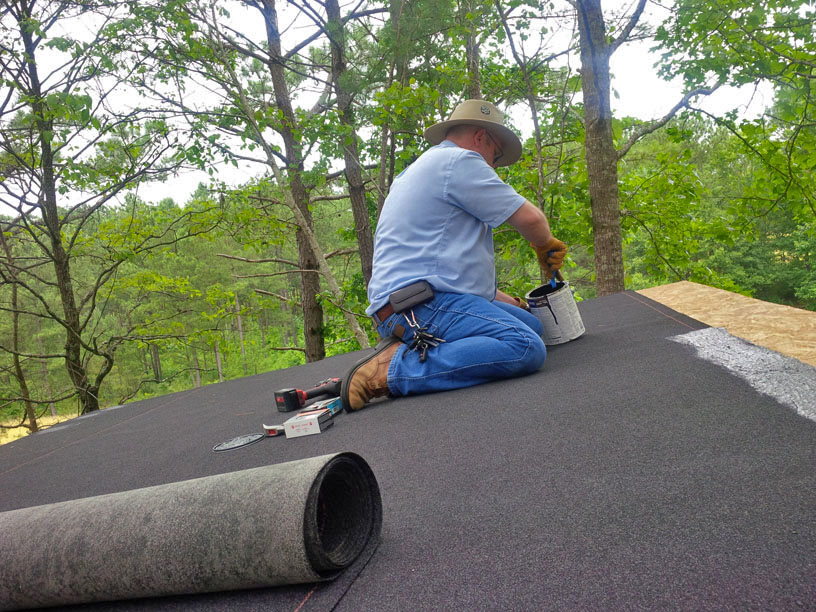

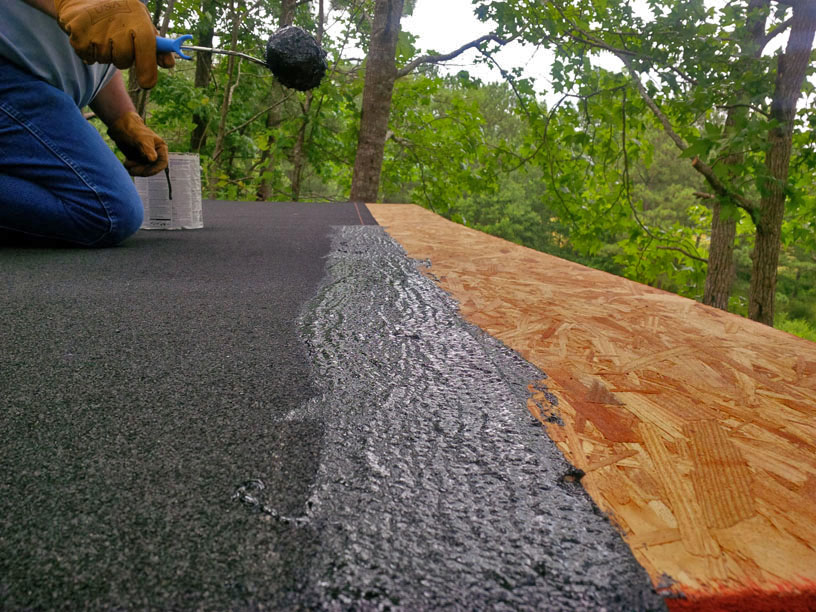

Tim using roofing adhesive
|
2:47
p.m. CDT June 18, 2016
|
2:47
p.m. CDT June 18, 2016
Each shingle roll section overlaps
|
5:08
p.m. CDT June 18, 2016
We ran out of staples!
|
5:21
p.m. CDT June 18, 2016

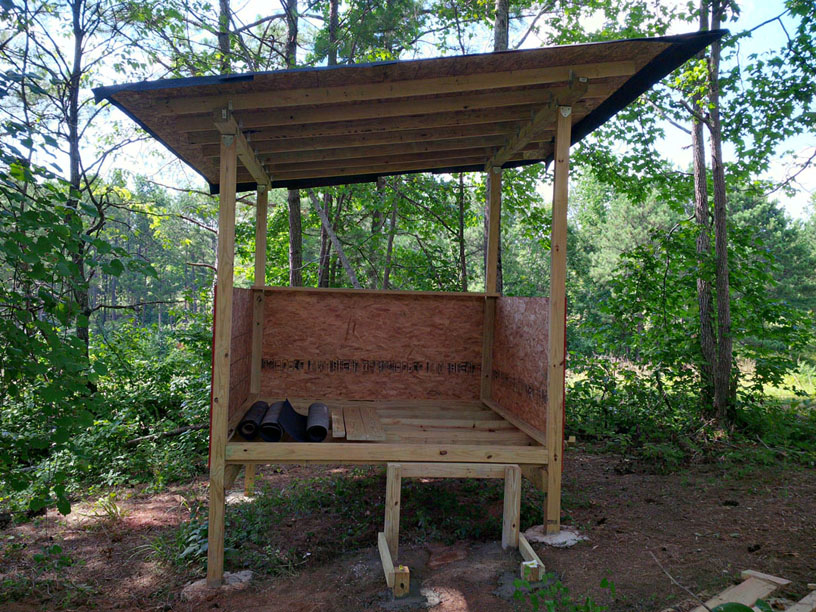

Roof 99% done
|

|

|

|

|

|
1:43
p.m. CDT July 2, 2016

Beginning on stairs on a HOT day
|
3:25
p.m. CDT July 2, 2016

Post hole digging is hard work
|
3:47
p.m. CDT July 2, 2016

Support is four 4"x4" posts in concrete
|
3:56
p.m. CDT July 2, 2016
Tim succumbed to the heat; we quit
|
3:57
p.m. CDT July 2, 2016

Stair supports done; steps come later
|
 |

|

|

|

|
11:16
a.m. CDT July 30, 2016

After a VERY hot month, we are back
|
11:24
a.m. CDT July 30, 2016

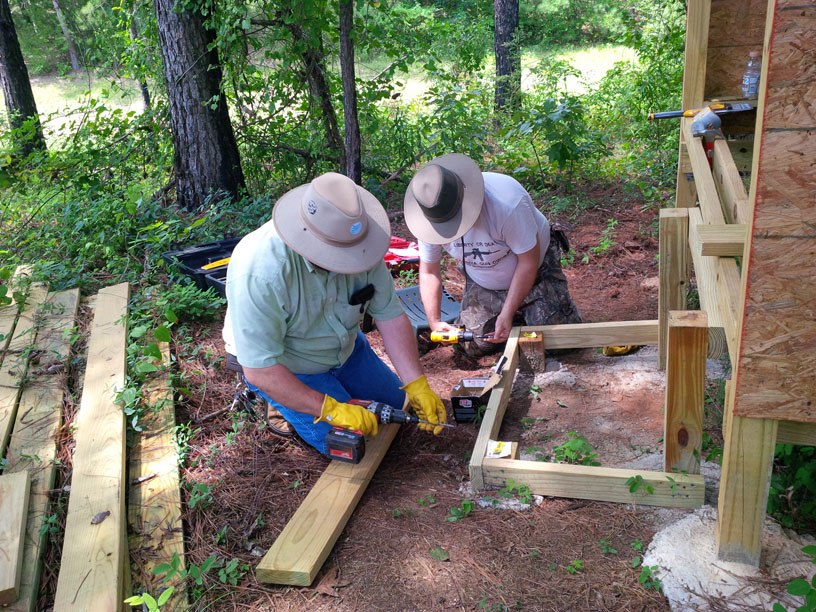

Tim and I work method to space steps
|
12:25
p.m. CDT July 30, 2016

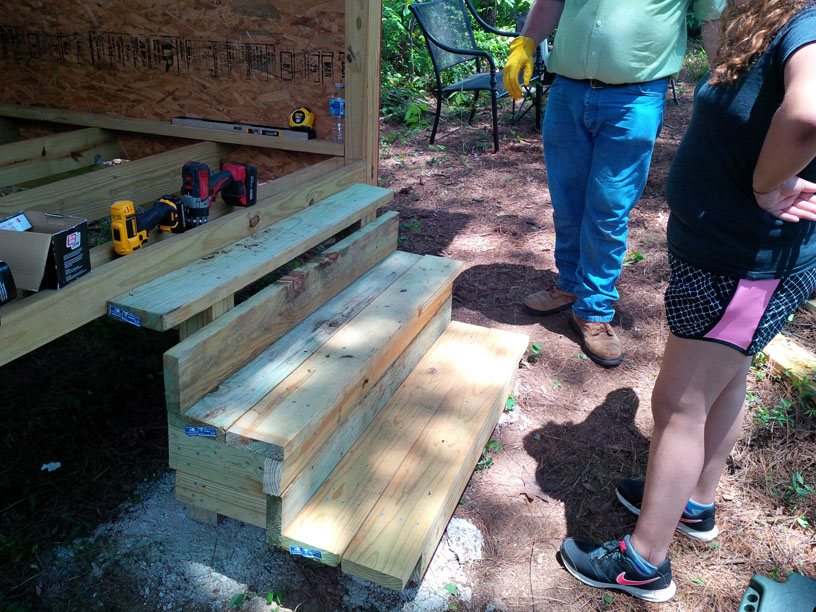

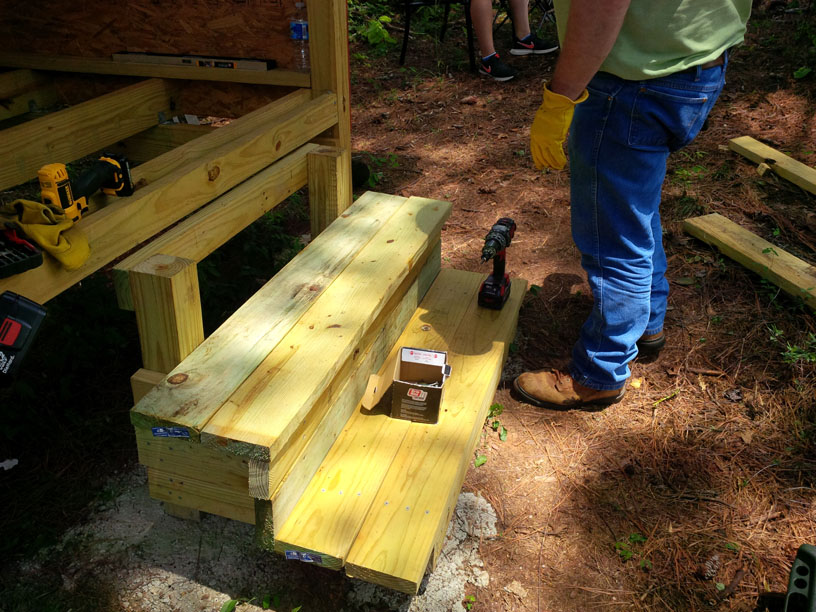

The middle step took the longest time
|
12:39
p.m. CDT July 30, 2016
The top step will not be as deep
|
12:59
p.m. CDT July 30, 2016

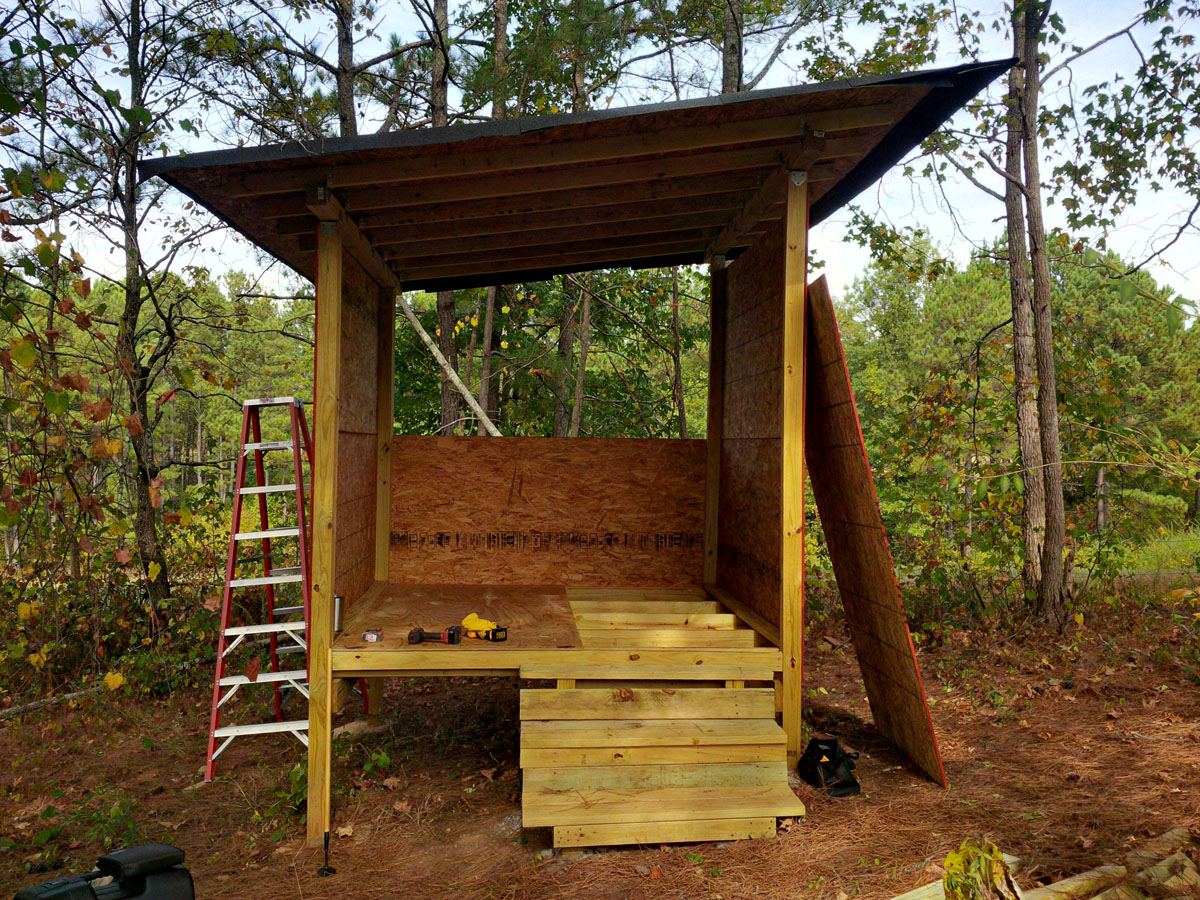

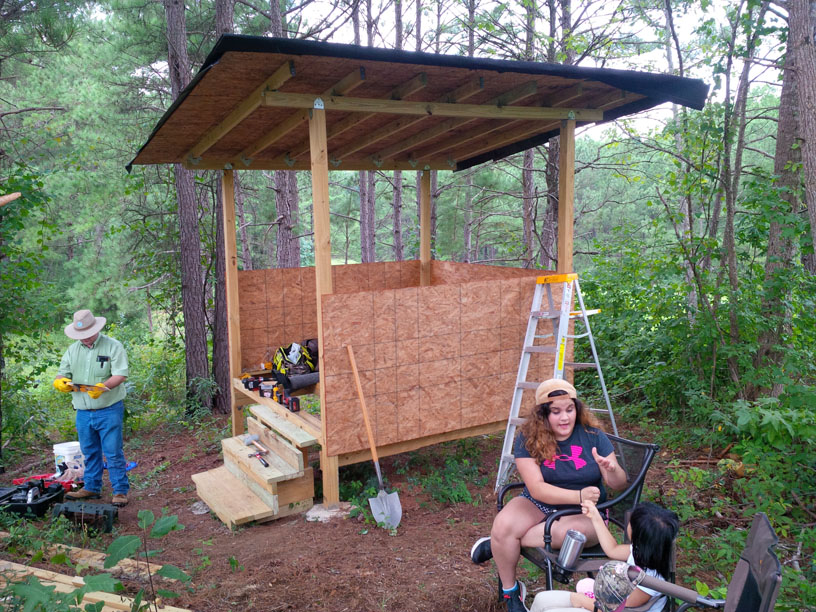

Stairs are 95% done (about to rain!)
|
